SGN have informed me that extensive essential gas works are due to take place on several roads across Findon Valley from Monday 11th August, to provide residents with a safe and efficient gas supply.
I have copied the information SGN has provided below, and they have reassured me that they will keep residents updated on this throughout. If you have any concerns or questions about the works that you’d like me to raise with SGN, please get in touch: [email protected]
Information provided by SGN:
From Monday 11 August for approximately nine months, SGN contractors I&G Contractors Limited will commence a significant programme of work to replace the gas main on various roads in Findon Valley in Worthing. Our engineers will be replacing the old metal gas pipes with new plastic pipes to ensure we can continue to provide a safe and efficient gas supply to residents and avoid gas leaks in the future.
Due to the location of our pipes in the road, we’ll need to have varying traffic management in place as we progress through the programme of work.

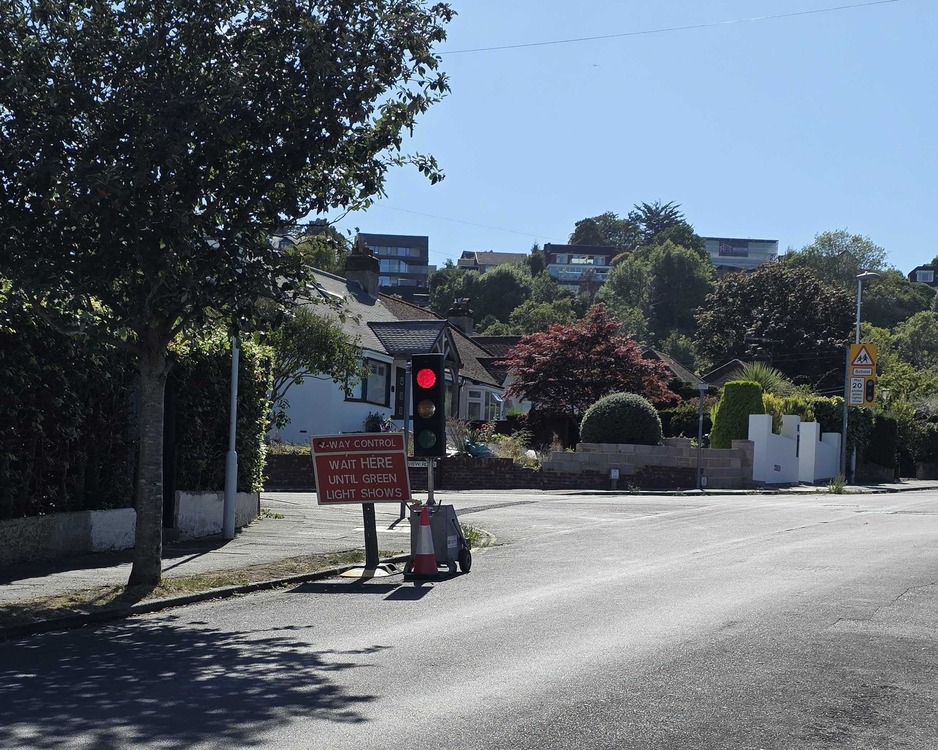

Traffic management affecting all roads – for the majority of the works traffic will be able to pass on a give and take basis; when we approach junctions we will need to have multi-way lights in operation as instructed by the local authority. When we work on junctions with the A24 we will need to have directional road closures in place, the direction of the closure will be dependent on the side of the road we will be working on. We’ll keep residents updated on the changing traffic management as we progress through the programme of work.
Below is an outline of our intended programme, please note these dates are for guidance and may change submit to permit approvals from the council.
Shepherd Mead: from 11 August to 17 October
A section of Shepherd Mead Road will be closed for the duration of our works for our mandatory compound area. Drawing below shows location of compound area in red.

- Vale Avenue: from 11 August to 27 September
- Central Avenue: 11 August to 06 March 2026
- Marshall Avenue: 25 August 2025 to 26 September
- Long Meadow: 25 August to 31 October
- Storrington Rise: 25 August to 31 October
- Downside Avenue: 01 September to 21 November
- Sullington Gardens: 08 September to 16 January 2026
- Downside Close: 15 September to 03 October
- Hollingbury Gardens: 06 October to 13 February 2026
- Cissbury Gardens: 27 October to 16 January 2026
- Cissbury Avenue: 10 November to 09 January 2026
- Cissbury Drive: 24 November to 16 January 2025
- Hazelhurst Crescent: 01 December to 23 January 2026
- May Tree Avenue: 05 January 2026 to 20 March 2026
- Findon Road: 02 February to 02 March 2026
- Lime Tree Avenue: 26 January to 03 April 2026
- Hillview Rise: 16 February to 20 March 2026
- Franklands Close: 16 February to 20 March 2026
- Ashfold Avenue: 2 March to 04 April
- Kearsley Drive: 16 March to 17 April
- The Heights: 30 March to 08 May 2026
- Allendale Avenue: 16 April to 11 May
- Mayfield Close: 27 April to 15 May
As we move through the programme of work, we’ll be communicating with residents and businesses affected. We’ll provide further details about the work, how it will impact you and vehicle access arrangements as these will change.
Please can we assure you; our engineers will be working as quickly and as safely as possible to complete these works without delay.
If you would like to speak to us about these works, please call our customer service [email protected] or call them on 0800 912 1700 they will direct your enquiry to one of the team for response.
Please accept our apologies in advance for any inconvenience we cause and thank you for your patience and understanding.
